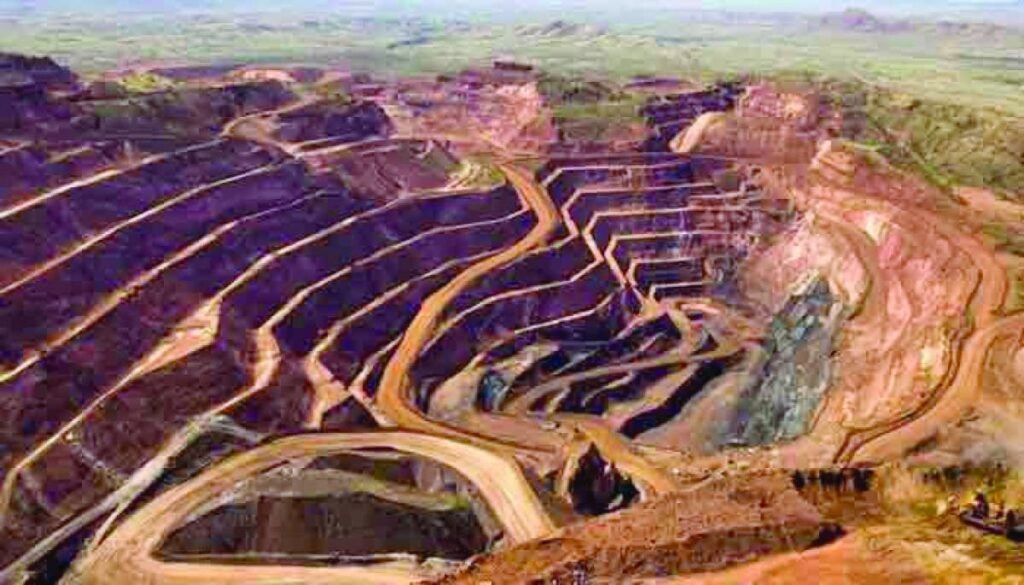

The federal government on Thursday approved the estimated cost of $7.723 billion and financial agreements for the first phase of the Reko Diq copper-gold project. This is Pakistan’s largest mining scheme which will be ready for formal signing within the next two weeks after final agreements are completed.
The approval came during a meeting of the Economic Coordination Committee (ECC) chaired by Federal Finance Minister Muhammad Aurangzeb. The ECC endorsed financial arrangements between state institutions, the Balochistan government and lenders.
Rising Project Costs
- Initial estimate (March 2025): $6.765 billion
- New estimate (September 2025): $7.723 billion
- Increase: 14%
- Major reasons for increase:
- Rising cost of loans
- Additional contingency expenses
Financial Structure
According to the ECC, significant changes have been made in the project’s financial framework:
| Component | Previous Estimate | New Estimate | Difference |
| Debt Financing | $3.0 billion | $3.5 billion | +$0.5B |
| Shareholders Investment | $3.765 billion | $3.446 billion* | -$0.319B |
* Conditional: If the project is completed at $6.946 billion, investment will be lower.
- Pakistan Minerals Private Limited (PMPL): $2.145 billion (post-debt: $1.173 billion)
- Balochistan Mineral Resources Limited (BMRL): $1.287 billion (post-debt: $704 million)
Project Timeline and Expected Returns
- Phase-I: First concentrate expected by end of 2028
- Phase-II: Reko Diq to be among the world’s top 5 mines
- Total expected mine life: 37 years
- Projected gross operating cash flow: $90 billion
- Revenue staying in Pakistan: $53 billion
Expected Revenues for Federation and Balochistan
| Beneficiary | Projected Revenue |
| Federal Government | $11 billion |
| Balochistan Government | $11 billion |
| Balochistan Free Carried Interest | $6 billion |
| BMRL Net Revenue | $9 billion |
| PMPL Net Revenue | $15 billion |
Socioeconomic Benefits
The project will not only bring billions of dollars into Pakistan’s economy but also provide major benefits to local communities in Balochistan:
- Clean water supply in Human, Mashki Chah, Nok Chah and Durbin Chah villages
- 7 primary schools to be established
- Training programs for local youth
- 27 Baloch graduates sent abroad for training
- 300 students from Chagai district enrolled in Hunar Foundation programs

Employment Opportunities
- Construction Phase (2025–28): 7,500 jobs
- Operational Phase: 3,500 jobs
Rail Project, 1,350 km Track for Mineral Transport
The ECC also approved a $390 million bridge financing arrangement with Reko Diq Mining Company (RDMC) to construct a 1,350 km rail line from Balochistan to Port Qasim. This has been declared essential for the project’s commercial success.
- Loan tenure: 3 years
- Interest rate: SOFR + 250 bps
- Repayment: Bullet payment at maturity
The Ministry of Railways has been directed to update the ECC on progress by March 2026.
